In 2026, Amazon private label competition is fierce, but opportunities remain abundant. Many new sellers dive into China sourcing believing “2–3 months and we’ll have a bestseller live.” The reality is harsher: from idea to first shipment safely arriving at an FBA warehouse and going live for sales, the typical timeline is 4–9 months. Underestimating this leads to cash flow issues, missing Black Friday/Prime Day, inventory pile-ups, or forced liquidations at a loss.

Why does it take so long? China’s supply chain is stable, but it involves multiple layers: design iterations, compliance testing, logistics, and customs clearance. In 2026, customs inspections are stricter and compliance requirements are higher. This guide uses the latest data and real-world experience to break down every stage month by month, helping Amazon FBA sellers create solid plans, compress timelines, and avoid expensive mistakes.

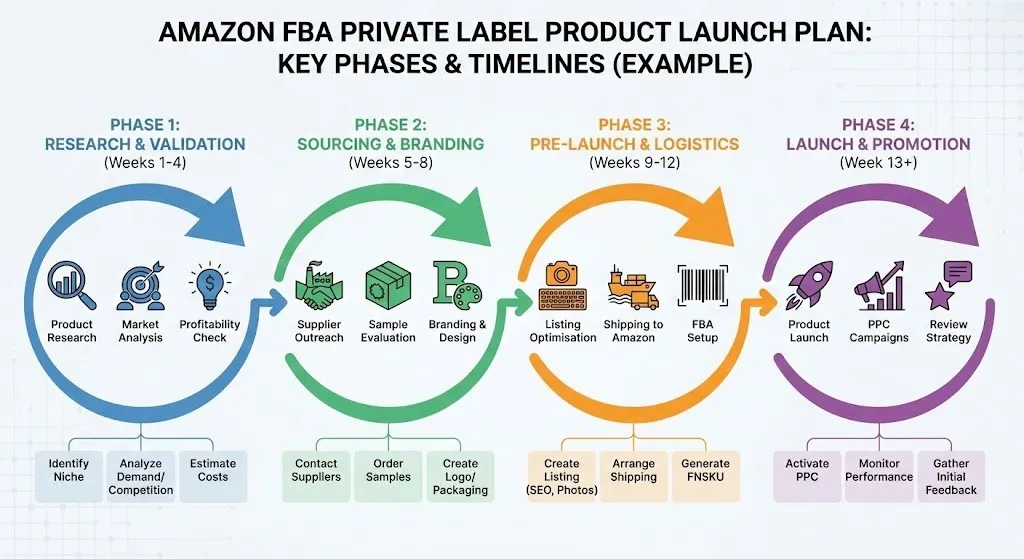

(Above: Example of an Amazon FBA private label product launch plan infographic showing key phases and timelines)

2026 Private Label Launch Typical Timeline Overview

Here’s the standard timeline for a medium-complexity product (e.g., kitchen gadgets, beauty tools, or home essentials). Simple categories (apparel/home goods) can compress to 4–6 months; complex ones (electronics/smart devices) often stretch to 6–10 months.

Stage Typical Duration Cumulative Months Key Deliverables Amazon FBA Impact Main Risks
1. Idea & Market Validation 1–2 months Months 1–2 Product feasibility report + target pricing Missing seasonal windows Over-research delaying start
2. Design & Tech Pack + Supplier Sourcing 1–2 months Months 2–3 Complete Tech Pack + supplier shortlist Listing keyword foundation Vague specs causing later changes
3. Sampling & Iteration 2–3 months Months 3–5 Golden Sample approved Real product photos/A+ content Excessive revisions
4. Tooling, Compliance & Pre-Production 1–2 months Months 5–6 Molds OK + compliance certificates Packaging/label compliance Test failures requiring redo
5. Deposit → Production → QC → Shipping 2–3 months Months 6–8/9 Finished goods at FBA Warehouse check-in + live listing Quality fade / logistics delays
6. FBA Arrival & Launch Prep 1–2 months (overlapping) Months 8–9+ Listing live + initial sales Stockout fees / overstock Inbound label errors

Category Differences: Apparel/home goods: 4–6 months; Electronics/beauty: 6–9 months (extra FCC/CE/FDA testing).

Stage 1: Idea & Market Validation (1–2 Months)

Everything starts here. Many sellers skip this and jump straight to factories, only to redesign everything later.

Key Steps:

  • Use Helium 10, Jungle Scout, or Keepa to analyze competitor sales, profit margins, and review pain points.
  • Calculate target pricing: cost + shipping + Amazon fees + desired margin (aim for 30–50%).
  • Validate demand: Google Trends, TikTok searches, Reddit discussions.
  • Assess feasibility: Confirm low-cost production is possible in China.

2026 Trend: AI tools (ChatGPT plugins or specialized product research software) speed up niche selection and filtering low-competition ideas.

Pitfall to Avoid: Don’t chase viral trends blindly—over-research delays launch; rushing leads to later pivots.

Stage 2: Product Design & Tech Pack + Supplier Sourcing (2–3 Months)

The core is turning your idea into a factory-understandable blueprint.

Key Steps:

  • Create a complete Tech Pack: dimension drawings, material BOM, Pantone colors, packaging specs, functional requirements.
  • Send RFQs (Request for Quotation) to 10–20 factories on 1688/Alibaba; shortlist 3–5 (see our guide: 1688 vs Alibaba Sourcing Guide 2026).
  • Negotiate MOQ, sample fees, lead times, and payment terms.

Pitfall to Avoid: Vague specs cause major sample deviations and repeated returns. In 2026, use AI factory matching to prioritize suppliers with existing similar molds for faster starts.

Stage 3: Sampling & Iteration (3–5 Months – The Biggest Bottleneck)

This stage causes 80% of delays. Typical 3-round process:

  • Round 1: Appearance/size sample (Look & Feel).
  • Round 2: Functional prototype (Working Prototype).
  • Round 3: Golden Sample—produced with real materials/molds.

Acceleration Tips: Use video/high-res photos for remote approval instead of physical returns; lock design early to minimize changes.

For more development details, see our full article: China Product Development Timeline.

Stage 4: Tooling, Compliance & Pre-Production (5–6 Months)

  • Mold creation (common for plastic/metal: 30–45 days).
  • Compliance testing: FCC/CE/RoHS/FDA (mandatory for electronics/beauty).
  • Pre-production sample (PP Sample) validation.

Related Guide: For electronics AQL inspection standards, see AQL 2.5 Quality Inspection Guide for Electronics.

Stage 5: Deposit → Production → QC → Shipping (6–8/9 Months)

After paying the 30% deposit, enter execution phase (typically 2–3 months).

Simplified Flow:

  • Deposit + 1–2 weeks: Raw materials arrival + production scheduling.
  • 2–4 weeks: During-production inspection (DUPRO).
  • 4–6 weeks: Final QC + packaging.
  • 6–10 weeks: Shipping (Air: 7–14 days; Sea: 30–45 days).

Key Rule: Pay the balance only after QC passes—this is your final leverage.

For deeper details on the post-deposit “black box” period, daily risks (e.g., material delays, sudden price hikes, inspection refusals), and red flags, read our in-depth guide: What Happens After You Pay the Deposit to a Chinese Factory?

Shipping Options: Air is fast but expensive; Sea is economical but slow; DDP (Delivered Duty Paid) is recommended for beginners to avoid self-clearance hassles.

Stage 6: FBA Arrival & Launch Prep (8–9 Months Endgame)

After goods arrive at FBA, there’s still 1–3 weeks of final steps:

  • Customs clearance + Amazon warehouse check-in (2026 inspections are stricter; DDP reduces rejection risk).
  • Sync listing: Leverage China-based product photography for A+ content (see our guide: Amazon Product Photography in China Advantage).
  • Initial inventory recommendation: 1000–3000 units to cover 2–3 months of sales—avoid stockouts or tied-up capital.

Even after arrival, sellers lose time here.Common issues:

  • Incorrect FNSKU placement

  • Carton label mismatches

  • Random warehouse inspection delays

Inventory tip: 1,000–3,000 units is usually enough for launch without overexposing cash.

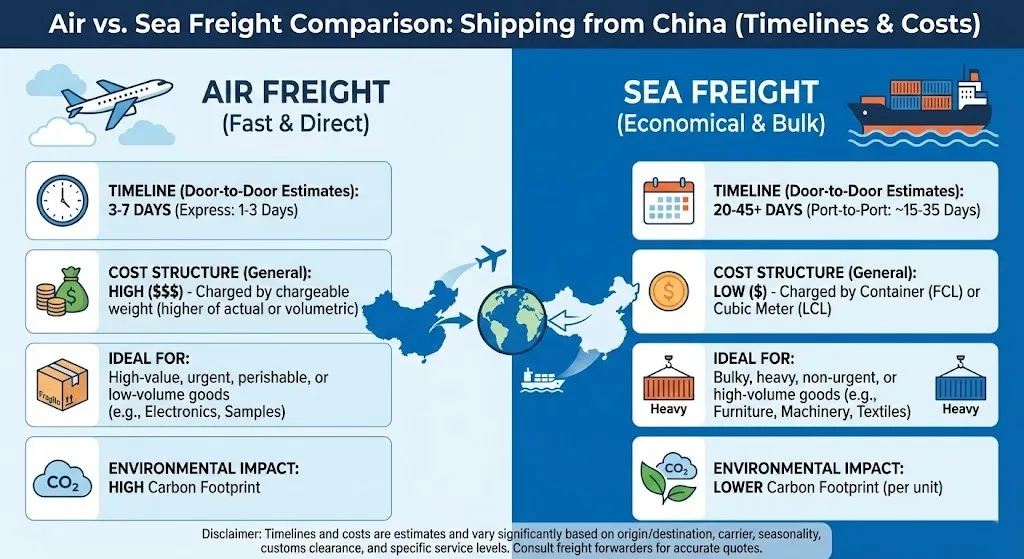

(Above: Air vs Sea freight comparison infographic for shipping from China, highlighting timelines and costs)

How to Accelerate the Entire Process? Practical 2026 Tips

Want to compress 8 months down to 5–6? Try these:

  1. Prepare a complete Tech Pack upfront — Avoid design-as-you-go to save 1–2 months on iterations.
  2. Use AI factory matching — Dark Horse’s tools can find suppliers with existing molds in just one week.
  3. Professional on-site monitoring — Weekly photo/video updates catch issues early.
  4. Bulk negotiation + secure payments — Use Trade Assurance or agency accounts (see Best Way to Pay Chinese Suppliers 2026).
  5. Choose Amazon-experienced factories — They know FBA packaging/labeling requirements.

Real Case: One client used AI matching + full oversight to shrink a kitchen product launch from 7 months to 5, hitting Q4 peak season perfectly.

Can You Compress the Timeline in 2026?

Yes—by 20–40%, if you remove rework.

Area Typical Seller Optimized Execution
Sampling 60–90 days 30–45 days
Compliance 30 days 10–15 days
Supplier Matching 3–4 weeks 7–10 days

Most Common Timeline Killers & Avoidance Checklist

  • Repeated design changes → Lock specs with internal reviews early.
  • Supplier ghosting → Contract specifies update frequency.
  • Compliance failures → Pre-select factories with existing certifications.
  • Logistics delays → Build buffer time + use DDP.
  • Missing seasonal peaks → Plan from the idea stage with calendar in mind.

FAQ

  1. How long does it take to launch a private label on Amazon from China in 2026? Realistically 4–9 months, depending on category and preparation.
  2. Can I speed up the China sourcing timeline? Yes—complete Tech Pack, AI matching, and professional oversight can cut 20–40% of time.
  3. What if my supplier delays after deposit? Enforce contract clauses + third-party QC; see our deposit guide for details.
  4. Is a 3‑month launch ever realistic?Only for extremely simple products using existing molds—and even then, it’s risky.

  5. When should I start for a Q4 launch?At least 6–9 months earlier.

Conclusion

Timeline planning equals cash flow and profit protection. Don’t let “3-month launch” myths derail your Amazon journey. Map out each stage properly to burn less money and earn more.

Need a free 2026 timeline estimate for your product? Or AI-matched factories? Submit your idea here—Dark Horse Sourcing team responds within 24 hours – Empowering Amazon sellers with end-to-end China-to-FBA solutions.
